Hesco Barrier Phase 1 + 1A
Latest Updates
3/11/2026: CBJ, with technical assistance from USACE, is finalizing plans to raise, repair and reinforce the existing Phase 1 HESCO barriers before the next GLOF event. Implementation and construction will begin in mid-to-late March 2026. Impacted property owners and residents have been notified.
10/30/2025: The USACE accepted CBJ’s request for USACE Public Law 84-99 Advance Measures Assistance to protect against the increasing future glacial lake outburst floods. USACE will provide installation for a Phase 2 of temporary flood barriers and technical assistance for Phase 1 repairs and reinforcement.
7/30/2025: The Phase 1 and 1A HESCO barrier installations are complete. CBJ is confident that the barriers will provide protection as designed, however, the City plans to issue an evacuation alert for the prospective inundation area during a 2025 Basin release and strongly encourages residents in the area to evacuate until the water recedes.
6/2/2025: The CBJ Assembly decided not to move forward with the proposed Phase 1B HESCO barrier installation until the appropriate funding discussions, community conversations and bank armoring could be completed. See the Assembly COW meeting recording and materials here.
See “Timeline & Status” below for additional updates.
Project Background
The Mendenhall River Valley in Juneau, Alaska is under imminent threat of unusual flooding from what scientific experts expect will be recurring and likely record-breaking glacier lake outburst flood (GLOF) events. The impact and inundation area of these events have increased each of the last three years; a pattern that puts hundreds of homes and thousands of vulnerable residents, as well as critical infrastructure, public facilities, and community and medical services at risk.
CBJ is working tirelessly with Federal, Tribal, State and local partners to gather the additional information and resources needed to identify and implement a long-term solution. However, a long-term solution will take years before it can be implemented due to the unusual source and nature of the flooding and the complex hydraulics and engineering required.
Therefore, emergency mitigation and immediate flood resilience action was needed to provide practical protection of the most vulnerable in our community before the 2025 GLOF season, and until a long-term solution is in place.

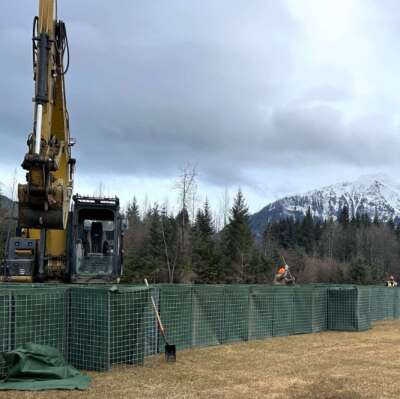

With extensive consultation and involvement from United States Army Corps of Engineers (USACE) flood fighting experts, CBJ installed USACE provided HESCO barriers as a near-term solution to mitigate potential widespread damage from future releases. Based upon factors such as the high-water marks obtained after the 2024 and 2025 GLOF events and the resources available to implement a solution before July 2025, an approximately 2 mile stretch of riverbank was identified which would provide the most protection to the highest number of flood-vulnerable residents and homeowners. This is considered Phase 1 of CBJ’s formal flood mitigation efforts.
After the completion of Phase 1, CBJ moved forward with Phase 1A of the project which included the installation of an additional 3,000ft of HESCO barriers south of Phase 1. Phase 1A was constructed on CBJ property and protects community assets such as two schools, a pool, library, and field house.
CBJ, with technical assistance from the USACE, is now moving forward with repairs, raising and reinforcement of the Phase 1 and 1A HESCO barrier after learning from the 2025 GLOF. This significant repair and reconstruction work will begin in March 2026 for completion in July 2026. Initial funding is provided by an Assembly transfer of funds from the Capital Civic Center project.
The USACE is providing Advance Measures flood fighting support with riverbank armoring and installation of temporary (HESCO) flood barriers along the remaining unprotected, populated riverbank areas of the Mendenhall River – referred to as Phase 2 – to construct a fortified, complete temporary flood barrier prior to July 15, 2026.

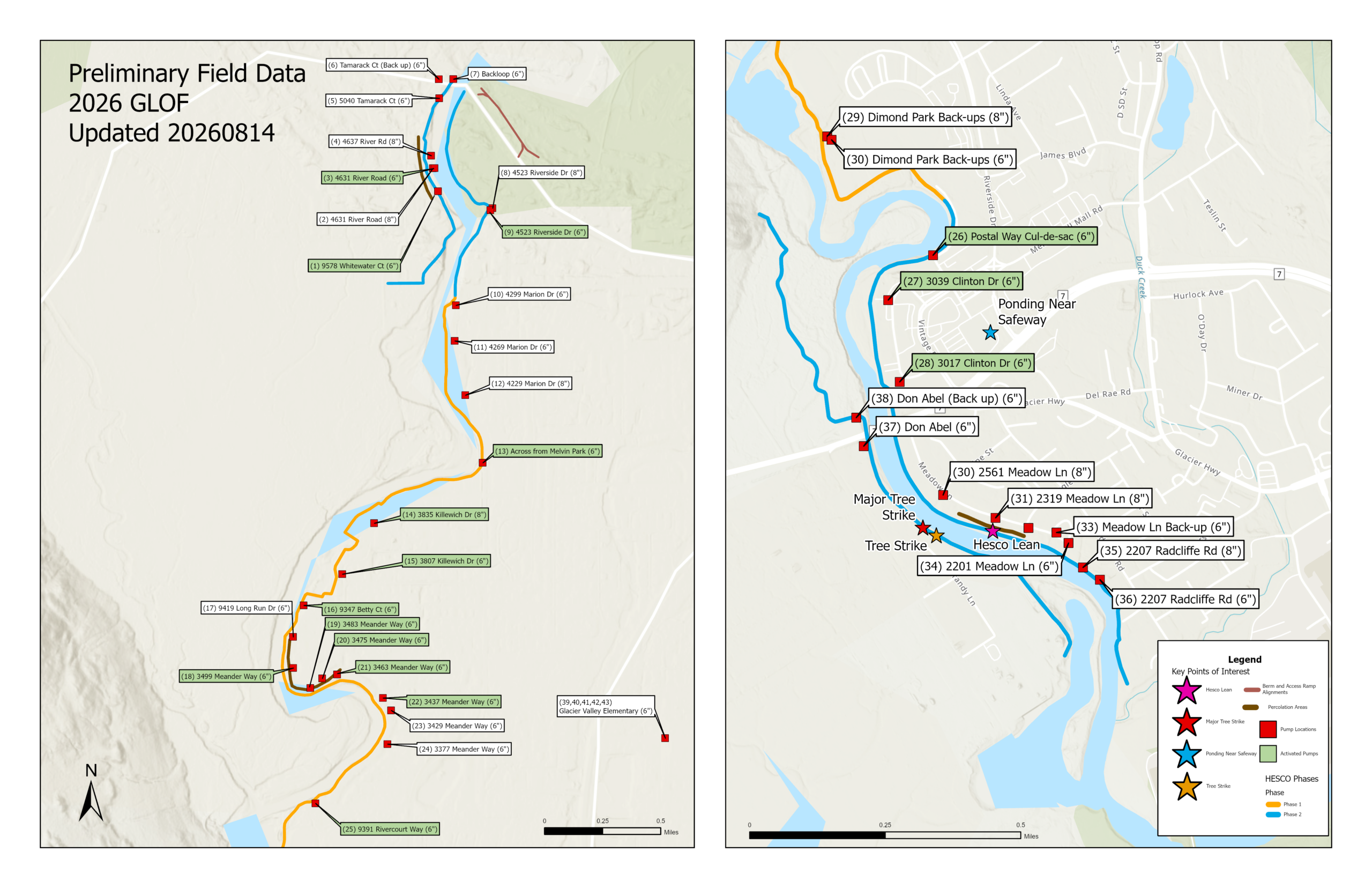

This interim flood fighting solution is intended to provide practicable protect against GLOFs that are up to 18ft high and was guided by the work of a comprehensive hydrological and hydraulic analysis and mapping. The inundation modeling shows that Phase 1 did not cause negative upstream or downstream consequences. More information on the inundation modeling and interactive mapping tools are available at JuneauFlood.com.
Contact Us
- To comment, provide input, or for general project inquiries, please email [email protected].
- Visit juneau.org/manager/flood-response for more information on CBJ’s ongoing flood response efforts.
